Your precast building, step by step

A precast building is completed in nine steps. We run six of them and three are yours. For each step you will find who works on it, what we need from you and what you receive at the end.

1. First meeting

Responsible
Sales and Quotes
teklif@bettonprefabrik.com
Needed from you
Province and district, use, rough width, length and height. A site plan or architectural drawing if you have one.
Output
Whether the building suits a precast system, and a list of missing information.

We ask early about a mezzanine, an overhead crane and roof solar panels; each changes the element sections.

2. Quote file

Responsible
Sales · Engineering office
proje@bettonprefabrik.com
Needed from you
The confirmed details from the first meeting.
Output
A referenced quote file.

The design data sheet shows the assumptions behind the quote. The price is based on the concrete volume of the elements and given per m².

In the quote file

  1. 1. Erection plan

    Grid layout and the code, position and number of every element.

  2. 2. Mezzanine and section drawings

    Heights, mezzanine beams and floor slabs.

  3. 3. 3D view

    A visual of your building, produced from your drawing.

  4. 4. Design data

    Span, height, grid spacing; seismic, soil, snow, wind and solar panel loads.

  5. 5. Element list

    The type and number of every element.

  6. 6. Scope and payment terms

    What we do and what stays with you, listed separately.

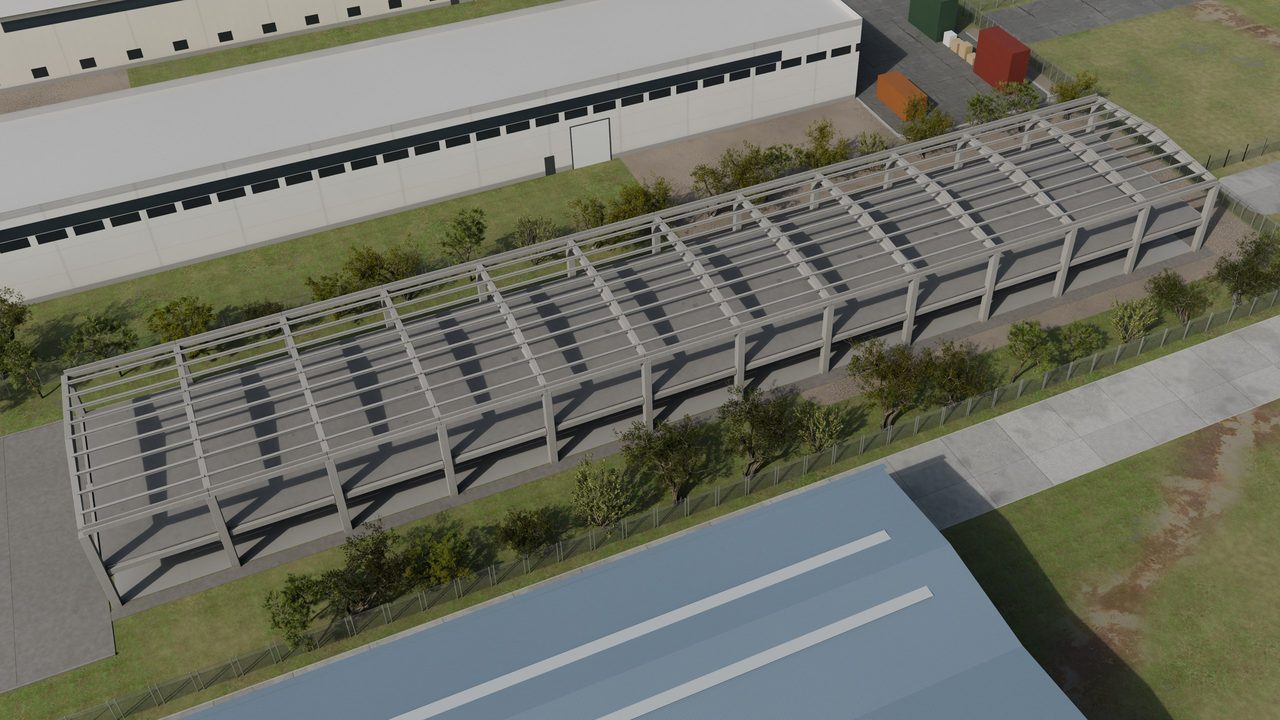

Project visualization: bird's-eye view of the same building, showing girders, purlins and the mezzanine.Project visualization
A 3D view produced from the client's drawing; not a photograph of a finished building.

3. Contract and final data

Responsible
Sales · Management
yonetim@bettonprefabrik.com
Needed from you
Quote approval, payment terms and the final design data in writing.
Output
Duration and payment plan.

The overall duration is agreed with you once the quote is accepted and the final design data reach us in writing.

4. Soil report

This step is yours
Responsible
Client
Needed from you
Soil investigation report.
Output
Structural design can start.

The quote uses assumed soil values; if the report differs, sections or reinforcement may change and so may the price.

5. Structural design

Responsible
Engineering office
proje@bettonprefabrik.com
Needed from you
Architectural design and soil report.
Output
Structural calculations, foundation design and working drawings.

Calculations reflect the seismic and climate conditions of your site.

45working days

From the day we receive the soil report to the structural and foundation design.

Design basis

  • TS 500Design of reinforced concrete
  • TS 498Design loads for buildings
  • TS EN 13369Precast concrete, common rules
  • TS 3233Design of prestressed concrete
  • PCI Design HandbookPrecast and prestressed design
  • TS EN 1991-1-3Snow loads
  • TBDY 2018Turkish seismic code
Drawn by
Draws the sheet
Calculations
Runs the structural design
Checked by
Checks drawing and design
Approved by
Approves the sheet
Signature fields of our title block, simplified.

6. Permits and foundations

This step is yours
Responsible
Client
Needed from you
Building permit, inspection and approvals; foundations, sockets and tie beams.
Output
Foundations ready for erection.

Permits, inspection fees and their charges are outside our scope. Foundations, sockets and tie beams are built by you to our design.

7. Factory production

Responsible
Factory and Production
Needed from you
Nothing; we keep you informed against the schedule.
Output
Elements made to the design, each with a record.

Every pour is logged in BÜTS with element, quantity, person and time; quantities lock at the design count.

Our standard quote terms
ElementConcreteSteel
Prestressed elementsC40/50270K prestressing strand, TSE-approved reinforcing steel and mesh
Non-prestressed elementsC30/37TSE-approved reinforcing steel and mesh
Prestressed roof girder stamped with the BETTON mark, with purlins and the valley behind it.

Food production plant, İslahiye / Gaziantep. Photo April 2026

8. Delivery and erection

Responsible
Factory · erection crew
Needed from you
Site access for trucks, a crane pad and finished foundations.
Output
An erected structural frame.

Elements are loaded in erection order. The crane and erection are within our scope; days lost to rain, snow or natural disasters are added to the schedule.

Top-down shot showing the grid of the precast frame and the rhythm of the roof purlins.

Food production plant, İslahiye / Gaziantep. Photo April 2026

9. Finishing works

This step is yours
Responsible
Client
Needed from you
Commissioning the works outside our scope.
Output
A building ready for use.

Works that stay with you after erection

  • Gutter sealing, downpipes and drainage
  • Façade panel joint sealing
  • Topping concrete and wet joints in mezzanine buildings
  • Paint, stairs, partition walls and joinery

Responsibilities

Responsibilities
WorkBETTON PREFABRİKClient
Quote file, erection plan, 3D viewBETTON
Soil investigation reportClient
Structural and foundation designBETTON
Permits, building inspection, fees and approvalsClient
Foundations, sockets and tie beamsClient
Factory production of the precast elementsBETTON
DeliveryBETTON
Crane and erectionBETTON
Gutters, downpipes, drainageClient
Façade panel joint sealingClient
Topping concrete and wet joints (buildings with a mezzanine)Client
Paint, stairs, joinery and other worksClient

Design data in the quote file

The design data sheet in the quote file has five groups and shows the assumptions behind the quote.

  1. A. Location

    • Province and district
    • Structural system
    • Building class
  2. B. Areas

    • Precast frame area
    • Mezzanine area
    • Façade panel area
  3. C. Frame dimensions

    • Width in girder direction
    • Length in gutter direction
    • Height
    • Column spacing, bay width and number
  4. D. Mezzanine and crane

    • Mezzanine dimensions and height
    • Mezzanine load and position
    • Crane load, position and runway beam
  5. E. Seismic and loads

    • Ground motion level, soil class
    • Importance and occupancy class
    • Snow, wind, roofing and solar panel loads
    • Roof pitch

When does the quoted price change?

Only if soil values differ from those assumed, if steel, cement, aggregate, strand or mesh prices change before confirmation, or if you add a requirement in writing.

The total concrete volume of the elements is divided by the building area; the result is the price per m².

Frequently asked questions

How long does a precast building take?

It depends on size, mezzanine, when the soil report is ready and when foundations are finished; it is agreed in writing after the quote is accepted. Our first firm deadline is the structural design: 45 working days from the soil report.

Do you build the foundations?

We design them; the client builds them. Sockets, foundations and tie beams are outside our scope.

Let's start your project

Send us the location and rough dimensions; we will ask for anything missing from the quote file.

CallRequest a quote
